6/10 Contractor Piling Up Tens of Millions of Dollars in Change Orders - Despite Alviti's Promises
GoLocalProv News Team
6/10 Contractor Piling Up Tens of Millions of Dollars in Change Orders - Despite Alviti's Promises

Alviti has stated that the “design-build” process ensures that by selecting one company that is responsible for both the design of the project and the construction, that it will eliminate rising project costs and change orders.
Too often, Alviti’s claims about the controversial 6/10 project have proven to be false.
GET THE LATEST BREAKING NEWS HERE -- SIGN UP FOR GOLOCAL FREE DAILY EBLASTRIDOT’s lead contractor Barletta Engineering/Heavy Division dumped tons of contaminated material next to homes in the Olneyville section of Providence.
Presently, the project is being investigated by both the United States Attorney and the Rhode Island Attorney General. Two of the families impacted by the contamination have filed lawsuits against RIDOT.

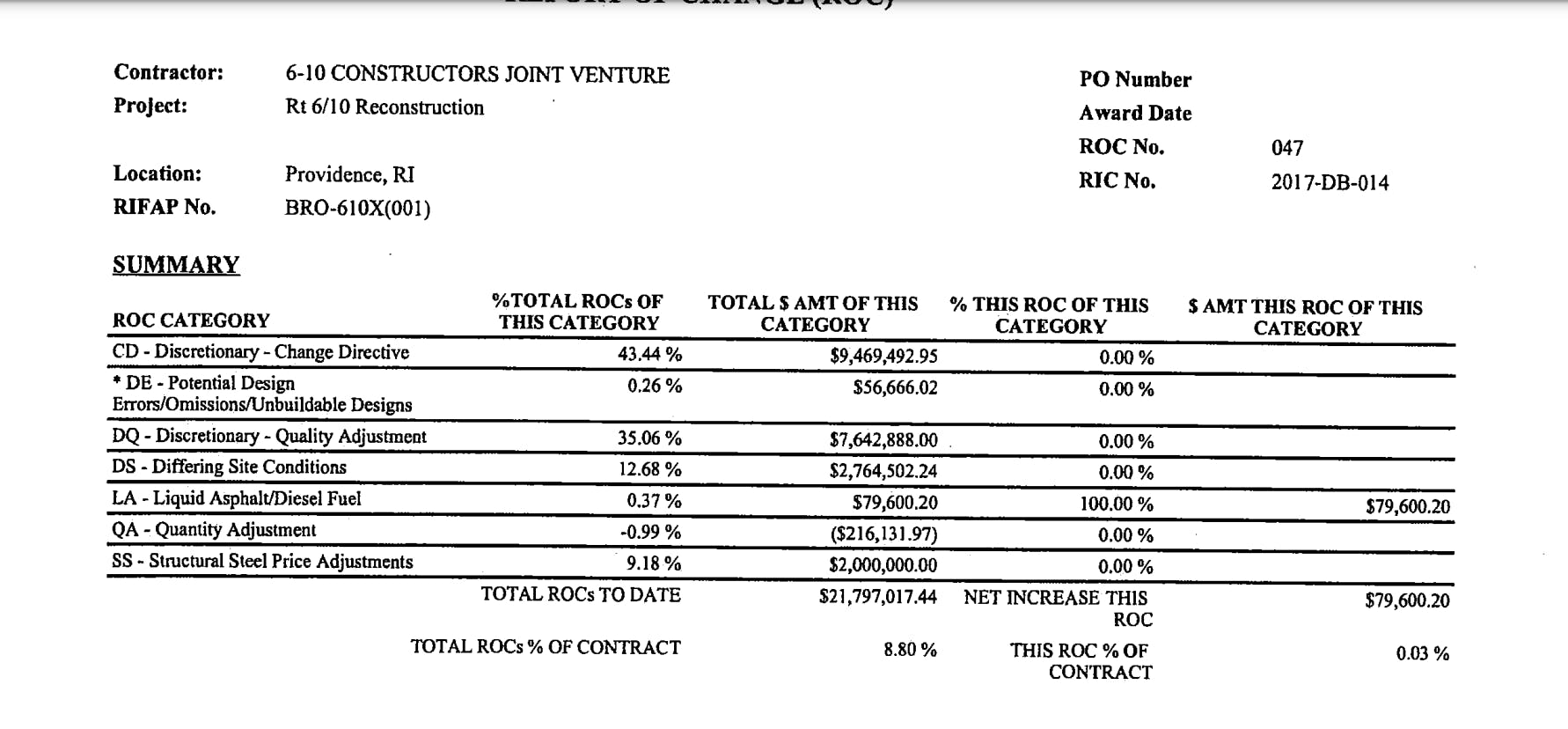

GoLocal has secured nearly 80-pages of documents that show that in the 6/10 construction project, the contractor submitted and received approval for more than $21 million in change orders from the beginning of the project thru August of 2021.
The 6/10 project was formally announced by state officials in January of 2018. Then-Governor Gina Raimondo, members of the Rhode Island Congressional delegation, Providence Mayor Jorge Elorza and Alviti praised the project at a press conference on January 8, 2018.
Barletta and its partners in the 6/10 Constructors Joint Venture's portion of the project won the bid at a price of $247 million. The project was awarded to 6/10 Constructors Joint Venture after it was, the Barletta claims, the low bid by “more than 80 million dollars.”
But, documents show the project was racking up tens of millions in change orders. The $21 million in cost overruns were submitted by the Barletta-led 6/10 Constructors Joint Venture.
That represents an 8.5% cost overrun through August of 2021.

At the time of the project's kickoff, WJAR-10 reporter, the late Bill Rappleye, reported in an interview with Alviti that the design-build approach would avoid "cost-overruns and change orders."
But, the change orders were filed by the dozens, and more may be coming.
The change orders include:
- $30,000 to reimburse the contractor for costs to design and install additional support for the electric duct bank at the end of the Broadway bridge
- Bridge maintenance $250,000
- Changes to the price of asphalt
- Changes to the price of diesel fuel
And on and on.

According to Alviti's spokesperson Charles St. Martin, "The 6/10 Project remains on schedule and is on budget. Under a design-build project, there are generally two instances where change orders are allowed: if RIDOT directs the design-build team to do additional work or identifies differing site conditions during the design process."
"An example of this flexibility in the design-build process was that the design-build team was able to design changes to the Amtrak catenary system as it passes under the bridges, originally expected to cost approximately $1 million. The decision to have the design-build team do this instead of RIDOT paying Amtrak to do it required a $300,000 change order but saved the project $700,000," he added.
Listed below is the description of some of the change orders provided as provided by RIDOT:
- $7.8 million for differing site conditions including escalating steel costs related to the imposition on tariffs in 2018 and National Grid and Amtrak work.
- $4 million for barrier changes due to the Department conforming to the Federal Highway Administration safety standards that were adopted after the project started.
- $3 million for road and bridge maintenance and inspection to keep the interchange safe and operational during construction. Work under this change order including paving, pothole patching, repairing nearly 90 beam ends, over 30 columns and piers, and dozens of bridge joints.
- $3 million in incentives to the contractor for not conducting weekend closures of Route 6. Every one of six weekend closures the contractor was allowed to conduct but did not need to resulted in a $500,000 incentive per weekend. No weekend highway closures were needed. Incentives are included in the RFP but not part of the design-build team proposal and subsequently added as a change order.
- $300,000 to pay for 24-hour tow truck coverage throughout the life of the project to remove any crashes in the interchange as quickly as possible and avoid extensive backups on the highway and in Olneyville.
"With every project RIDOT looks for ways to improve how it does business. Items such as accounting for the possibility of escalating material prices are now included in other current RIDOT projects and will be included in future ones," claims St. Martin.

As GoLocal unveiled in April of 2022, RIDOT awarded a $167.4 million contract to Skanska/JH Lynch -- they were the highest bidder for a contract for a project on Route 146.
“The best value award was made to Skanska/Lynch as the partnership with the highest combined score in the request for proposals. The award was made according to requirements set forth by the Rhode Island Department of Administration. The construction cost of the project is $167.4 million,” said St. Martin regarding the 146 contract.
